You can use the import wizard to import work into the planner. Simply paste the data to be imported into the import wizard.

To use the plan import the user requires all three create permissions to be set as the plan import can create new roles, resources and projects.

You can import agile and non agile work.

Import templates

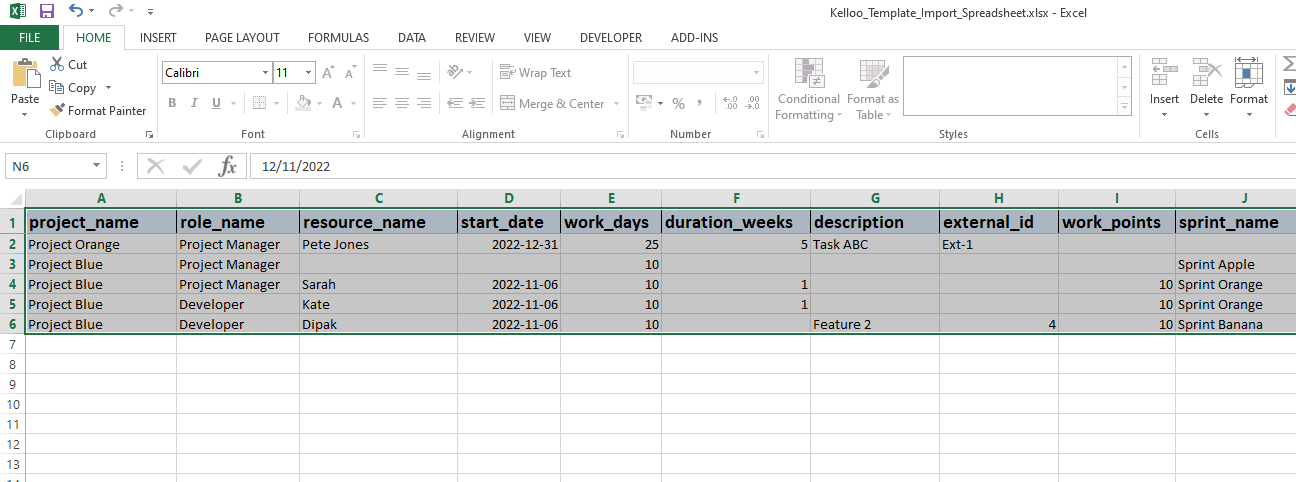

CSV import templates are available to download. Optionally use these to format your data for import.

Importing work

Here is how to use the import:

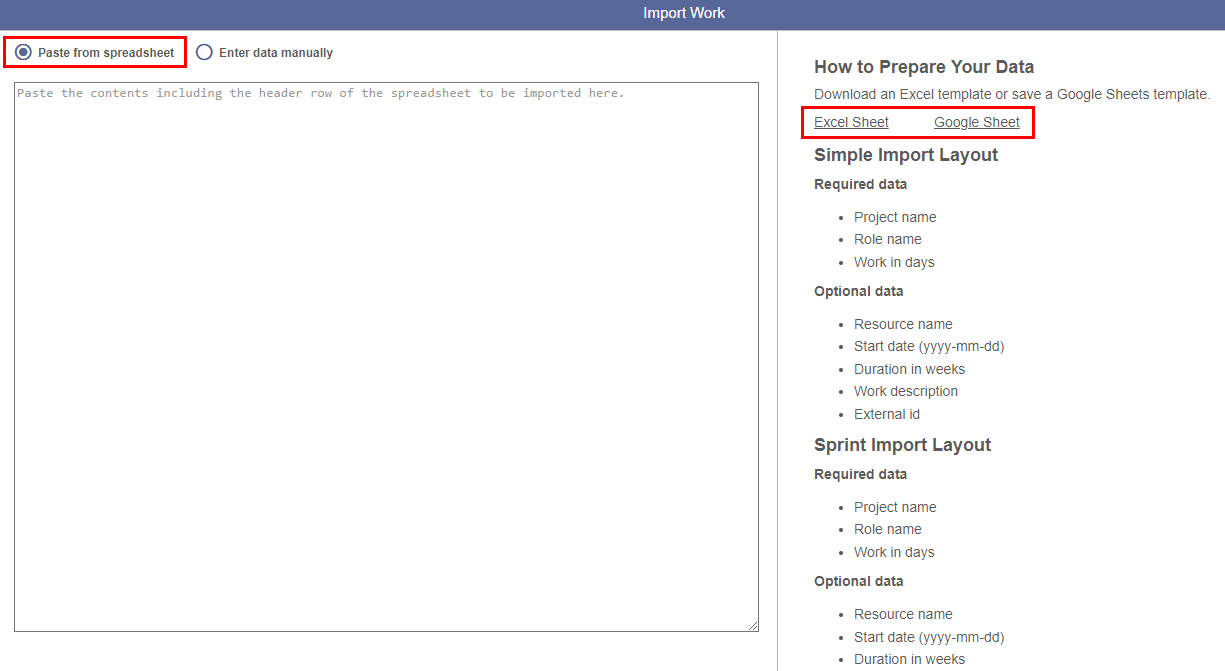

  • Within the planner, select import.

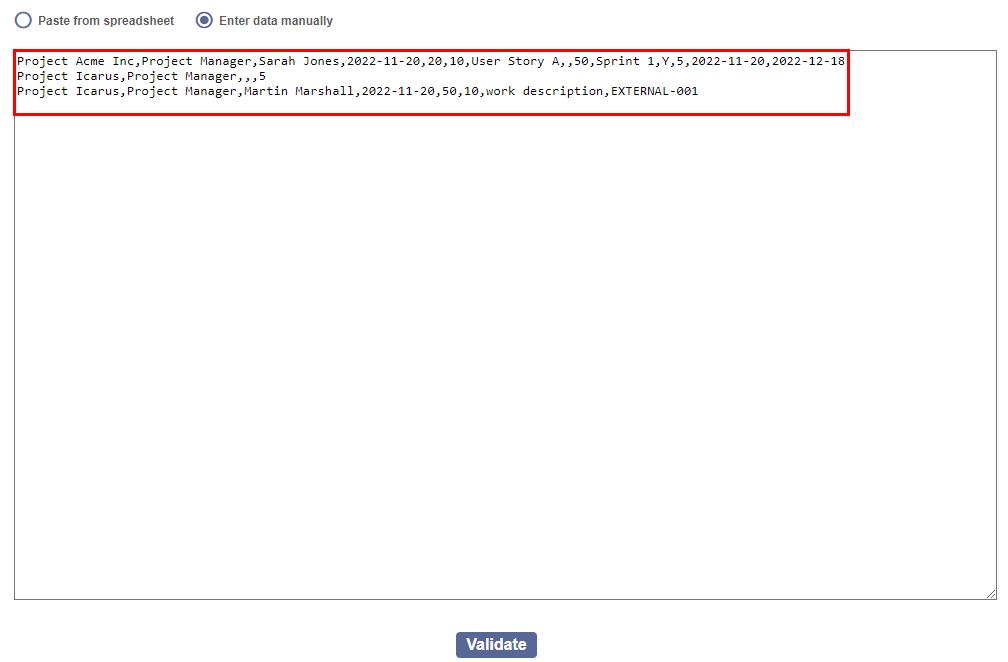

  • Paste your work data into the import box (one work assignment per row).

  • Select validate to check your data is ok to import.

If your data has no errors:

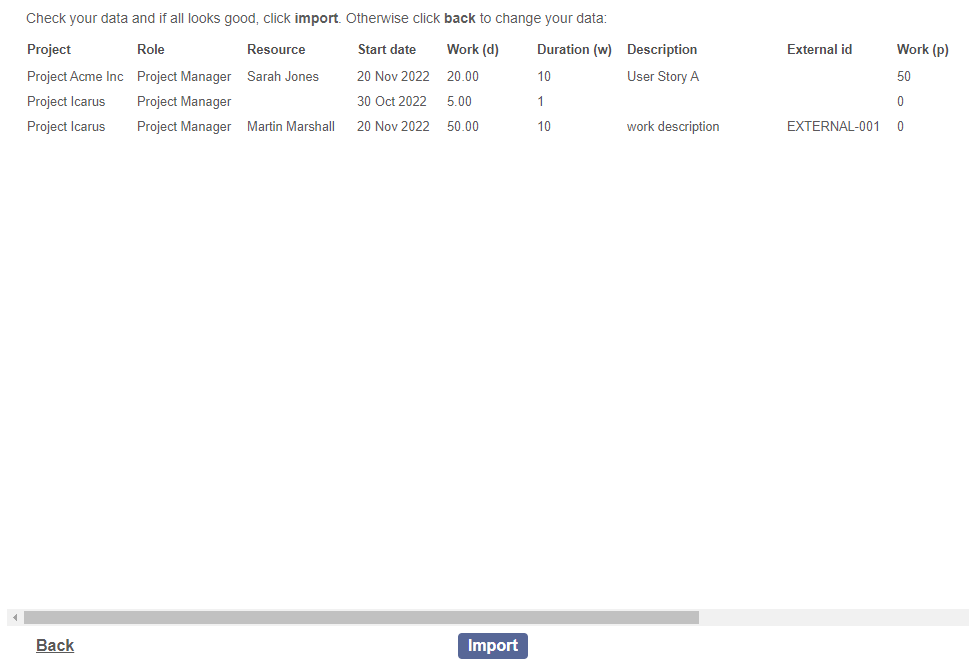

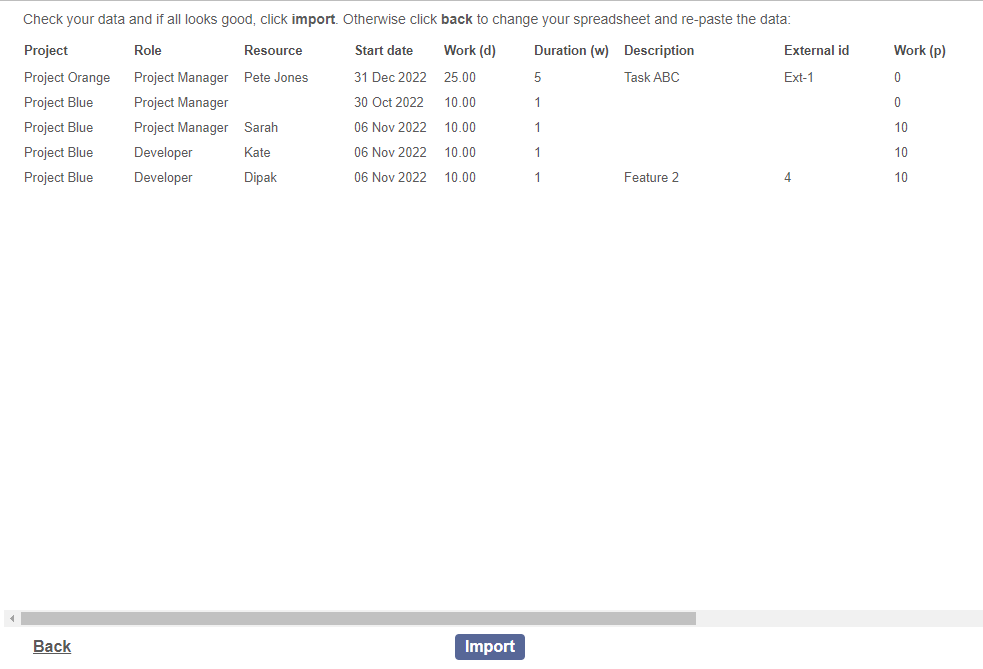

  • Review the data to be imported and click back to make any changes.

  • Otherwise click import to import the work.

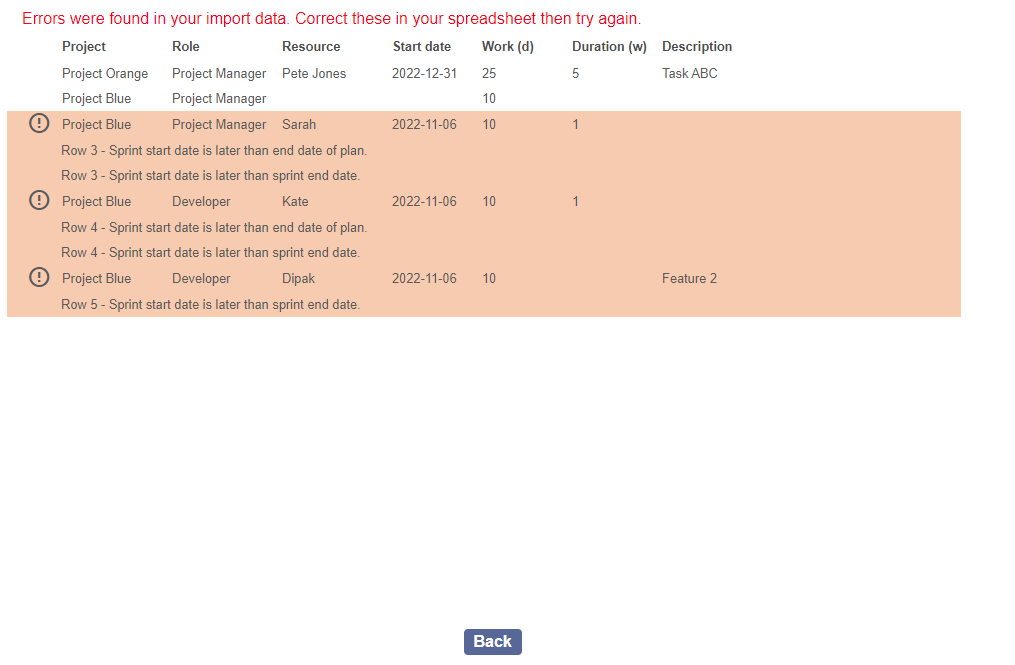

If your data has errors:

  • Click back, correct the errors then import again.

Notes

  • If a role or resource does not exist they will be created for you. Currently only creation of named resources is supported via the plan import. If you are using resource groups, import them or create them using the resources page then import work using the planner import.

  • If work is being imported for a resource and a resource with the same name already exists, the work will be assigned to the existing resource.

  • If a start date which is not a Sunday is used, work will be imported using the previous Sunday start date.

  • If work starts before today and finishes after today, the work will be split into two segments and the first segments work will be considered completed.

  • Enter only one work assignment per row.

  • Separate fields using a , (and fields must not include a , as data).

Import format

Non agile work - simple

Format: Project name,role,resource name,start date (yyyy-mm-dd),work in days,duration in weeks.

Example Data

Project Acme Inc,Project Manager,Sarah Jones,2016-08-10,20,10

Non agile work - additional

Additional fields can be imported about work.

If you choose to import any of the additional fields then all the additional fields must be completed for that row.

FieldMeaning
Project nameProject nameRequired
RoleResource roleRequired
Resource nameIf left blank, then the role will be assigned as the resource for the work.

If a resource (named resource or resource group) is supplied, it will be assigned to the work.
Required
DateStart date for the work in YYYY-MM-DD format.

If left blank then the current week commencing date will be used.
Required
Work in daysThe amount of work to be assigned in days.Required
Duration in weeksThe duration of the work in weeks.Required
DescriptionThe description of the work.Optional
External IDSee below.Optional

Agile work

Format: Project name,role,resource name,start date (yyyy-mm-dd),work in days,duration in weeks,description,external id,work in points,sprint name,use sprint dates,points per day,sprint start (yyyy-mm-dd),sprint end (yyyy-mm-dd)

Example Data

Project Acme Inc,Project Manager,Sarah Jones,2016-08-10,20,10,User Story A,1234,50,Sprint 1,Y,5,2016-08-10,2016-08-20

FieldMeaning
Project nameProject nameRequired
RoleResource roleRequired
Resource nameIf left blank, then the role will be assigned as the resource for the work.

If a resource (named resource or resource group) is supplied, it will be assigned to the work.
Required
DateStart date for the work in YYYY-MM-DD format.

If left blank then the current week commencing date will be used.
Required
Work in daysThe amount of work to be assigned in days.Optional *
Duration in weeksThe duration of the work in weeks.Required
DescriptionThe description of the work, can be blank.Required
External IDSee below, can be blank.Required
Work in pointsThe amount of points to be assigned to the sprint.Optional *
Sprint nameThe name of the sprint.Required
Use sprint datesY/y or N/n. If Y the work dates will be aligned to the sprint dates.Required
Sprint points per dayThe sprint points per day.Required **
Sprint startYYYY-MM-DD format, if blank current week will be used.Required **
Sprint finishYYYY-MM-DD format, if blank current week will be used.Required **

* Notes

Either work in days or work in points must be provided. If one is not provided then it will be calculated from the other.

** Notes

1. Only required for the first occurrence of the sprint in the import. If supplied for other occurrences of the sprint, the existing sprint values will be used.

2. If the sprint is already in the plan, values are not required as existing sprint values will be used.

Example given the data below

1. First record will set up the sprint data and create User Story A.

2. Second record will use the sprint data from the first record and create User Story B.

Project Acme Inc,Project Manager,Sarah Jones,2016-08-10,20,10,User Story A,1234,50,Sprint 1,Y,5,2016-08-10,2016-08-20

Project Acme Inc,Project Manager,Sarah Jones,2016-08-10,20,10,User Story B,1234,50,Sprint 1,Y

If the data below were then imported via a separate import, the sprint data from the plan for Sprint 1 will be used.

Project Acme Inc,Project Manager,Sarah Jones,2016-08-10,20,10,User Story C,1234,50,Sprint 1,Y

External ID

You an use the external ID to update work records via the import. Here is how it can be used.

Assign a unique external ID to work that is imported. If you subsequently import work with the same external ID, it will update the work in Kelloo rather than re-import it.

Here is a use case.

You import work from Jira into Kelloo.

  • The work has a unique ID imported from Jira.

  • So the Jira ID will be recorded against the work in Kelloo.

  • You re-import the work from Jira.
  • If Kelloo finds a match on the Jira ID in the Kelloo External ID field, it will update the work. Otherwise it will import it as a new record.

To edit the external ID, select more... from the edit panel.

Download import templates

Three import templates are available (download the attachments shown at the foot of the page).

Agile.csv This can be used to import both agile and non agile work.

Standard (non-agile.csv) This can be used to import non agile work (simple fields only).

Standard (optional data).csv This can be used to import non agile work (including additional fields).
